Remediation of the Bonfol hazardous waste landfill, Switzerland

Infrastructure and excavation lot

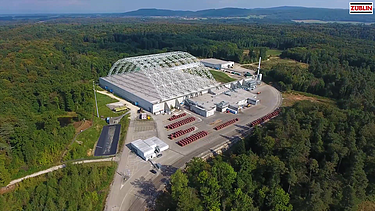

  • Aerial view of the enclosure over the landfill body ZUT
    Aerial view of the enclosure over the landfill body ZUT

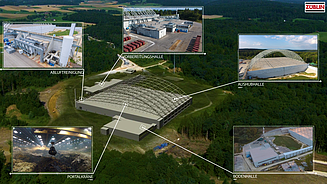

  • Overview of the treatment plants ZUT
    Overview of the treatment plants ZUT
Location
Bonfol, Switzerland
Industry/client
Industry
Parameters
Construction of the movable hall as an arch construction made of steel framework with suspended ceiling, span of up to 150 m, length approx. 122 m and moving of the hall during the remediation works.
Excavation of approx. 200,000 tons of hazardous waste and approx. 50,000 tons of contaminated soil within the closed hall.
Performance period
2009-2017

In the 1960s and 1970s, mainly waste from the chemical industry was deposited in a former clay pit. At the time, the landfill complied with all current regulations and permits. 25 years after its closure, the canton of Jura demanded the complete removal of the landfill.
Following a functional call for tenders with an ideas competition, the "Groupment DIB", consisting of Züblin Umwelttechnik GmbH, Züblin Spezialtiefbau GmbH and other companies, won the contract to carry out the requested measures. The coherent concept with a movable column-free hall with a span of up to 150 m and two remote-controlled crane grab systems suspended from the hall structure for waste excavation was convincing, also in terms of execution.

Special features

  • The contract was awarded following a functional tender with an ideas competition

Scope of services

  • Approval and implementation planning for all structures, the exhaust air technology and the entire building and safety technology as well as the excavation operation.
  • Construction of the infrastructure on an area of 160,000 m² (paths, squares, railroad connection incl. all utility lines and civil engineering measures).
  • Outbuildings such as the visitor center, laboratory and offices.
  • Construction of interim storage, handling and loading areas as a reinforced concrete structure including all safety equipment.
  • Shifting of the excavation hall (2013), dismantling (2017)
Preview of the video ZUT
Video footage of the impressive, self-supporting hall construction of the enclosure building.

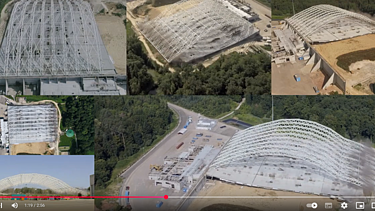

Demolition of the self-supporting hall airshoot.ch
The blasting of the self-supporting hall construction was also an experience.
